Milton Electric Improvements

Project Summary

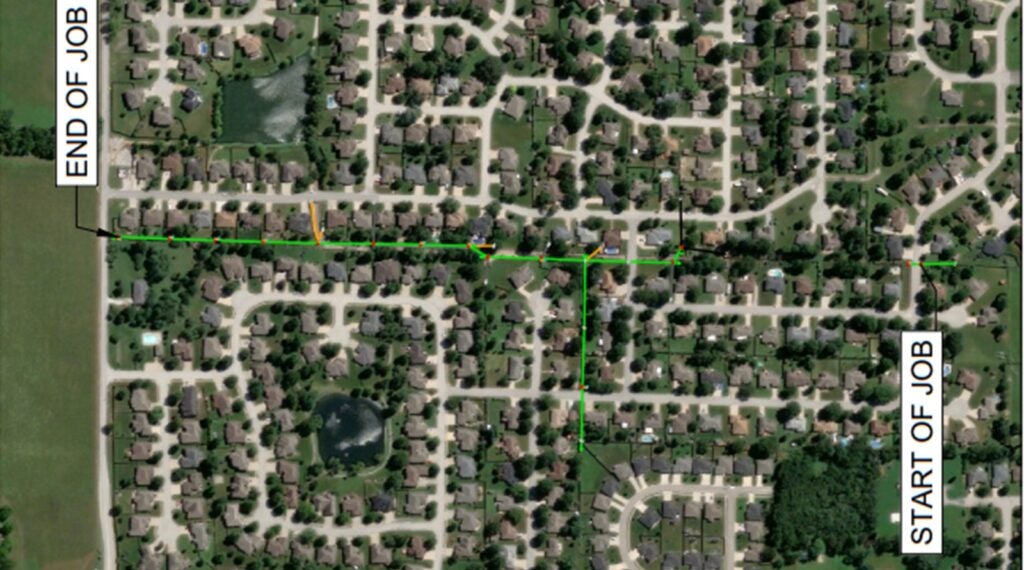

This project addresses system reliability and safety in an area where aging wire has failed. This project starts on Park Street and continues north to Northview along Milton Drive. This project is complete.

Project Quick Facts

Budget:

$159,174.34

Contractor:

BBC Electrical

Completion Date:

This project was completed on July 23rd.

This addresses one of the Electric Department’s priorities for 2026, which aims to address aging electric infrastructure to improve system reliability and address safety concerns.

July 23, 2026

Project Completed

This project is complete. It adds reliability along Milton Street.

May 22, 2026

Project Start Date

This project is anticipated to start on May 25th and have a construction window of approximately six weeks.
